Central Winchester Regeneration

The Council is seeking the comprehensive redevelopment of the Central Winchester area. This section contains all of the latest information on the Central Winchester Regeneration Project.

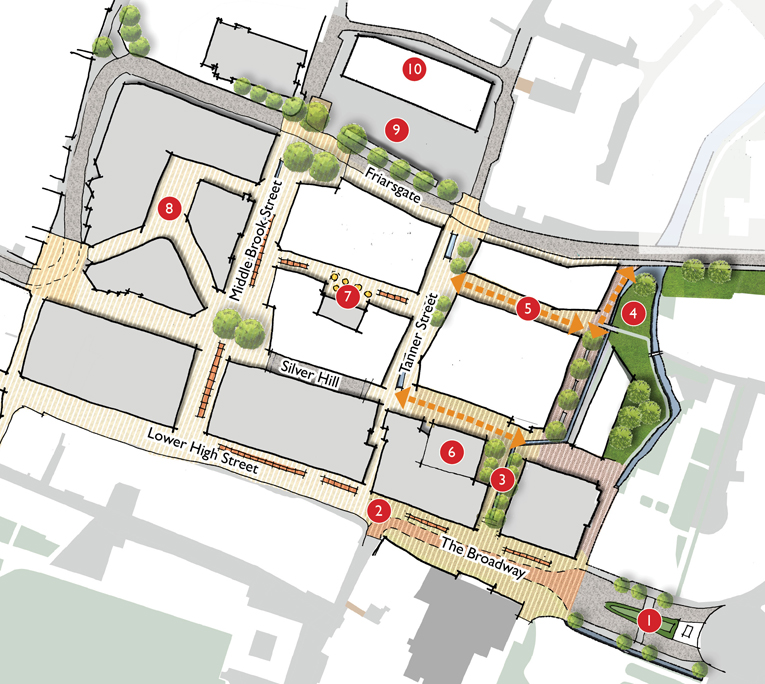

CWR SPD Framework plan

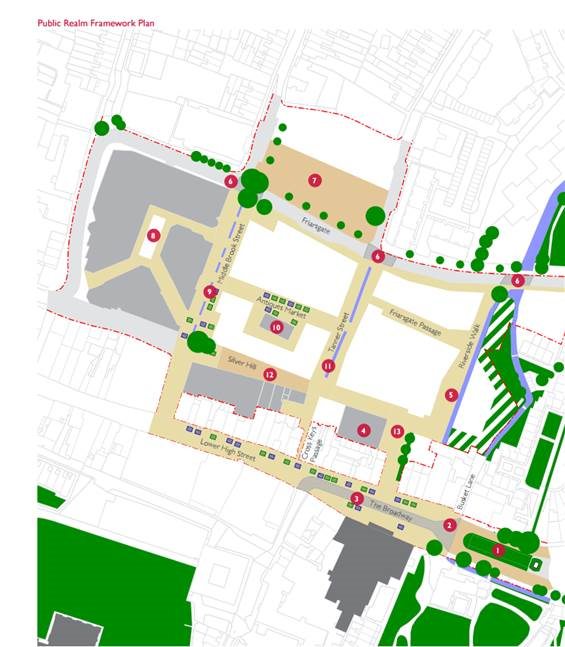

CWR public realm framework plan

SPD approved by Cabinet

The Supplementary Planning Document (SPD) for the Central Winchester Regeneration (CWR) area was adopted by Winchester City Council on June 20 2018. The CWR SPD supplements the policies within the adopted Local Plan (Parts 1 and 2) and sets out a vision, objectives and planning and urban design framework for the future development of the Central Winchester Regeneration area.  The SPD provides supplementary planning advice and guidance to prospective developers for regeneration within this part of Winchester and has been informed by an extensive community planning and consultation process. You can access the SPD and consultation statement here.

Latest news and meetings

For all the information on the latest information on this project:

Cabinet (Central Winchester Regeneration) Committee meetings

Central Winchester Regeneration news

Background

The Central Winchester Regeneration project will create a city centre which delivers for the people who live, work, study or visit here. We must preserve what makes Winchester special and build upon its distinctive style so our city stands out from other destinations in the region.

The vision for the centre includes proposals which balance retail, market, commercial, cultural, housing and community uses in a new city quarter. The new developments need to be economically viable and work for the city.

Maintaining what makes Winchester special with the character and scale of the buildings and streets is important. It’s a special site and we must get it right.

With a mix of active and restful spaces, opening up of the brook to the east of the site and developing the public realm the city centre will bring together the culture and history that has shaped Winchester in its natural environment.

Timeline

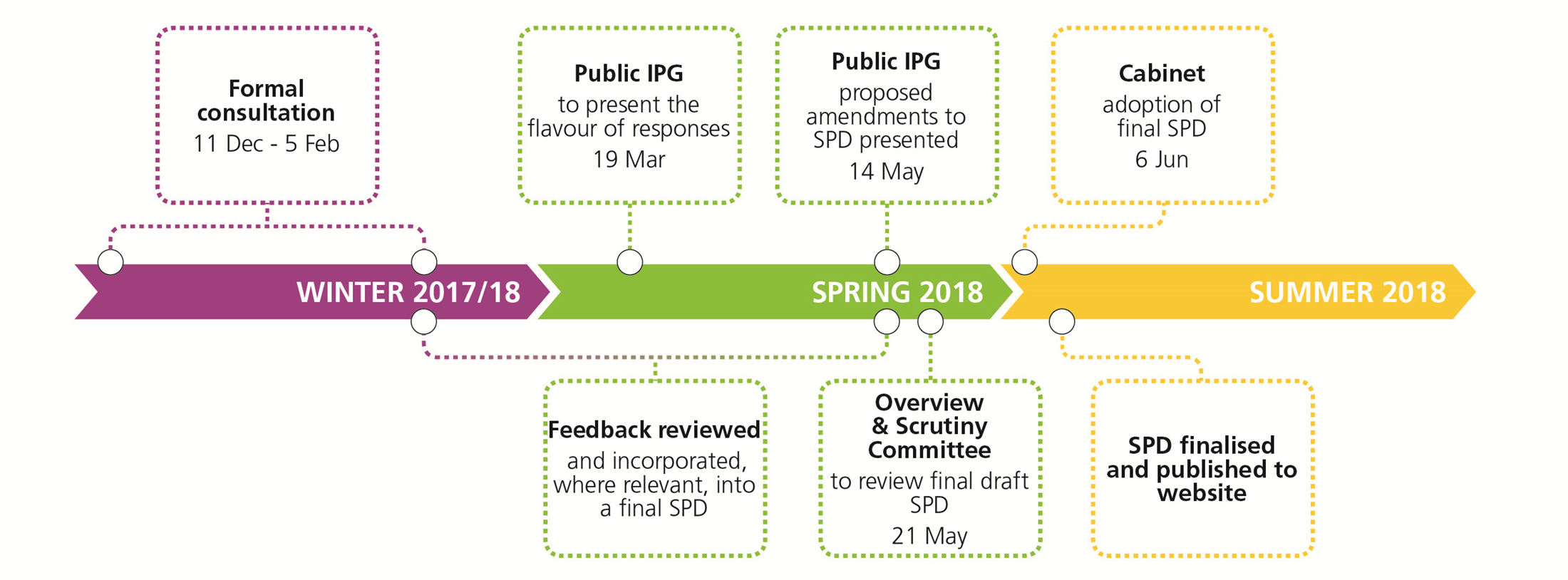

CWR timeline May18



Central Winchester Regeneration details

Portfolio Holder

Cllr Caroline Horrill

Start Date

29/03/2016

Key Steps/Milestones

Current Status

  • Archaeology public information evening Guildhall Winchester. Save the date 11 December 2018, 6.00pm - 8.30pm
  • Cabinet (CWR) Committee to pick up the next stage of the project - Autumn 2018 - in progress
  • Final SPD approved by Cabinet (CWR) Committee 20 June 2018 and successfully completed its statutory three month challenge period 20 September 2018

Milestones completed

  • Cabinet Project Initiation: 29 March 2016 – completed
  • Inaugural IPG Meeting: 13 September 2016 - completed
  • Workshop to discuss the public engagement strategy: 3 October 2016 - completed
  • IPG Meeting on archaeology and discussion of brief to commission work: 18 October 2016 - completed
  • IPG Meeting on bus facilities: 8 November 2016 - completed
  • Commission urban design practice with experience in public engagement- November 2016 - completed
  • JTP, award-winning 'placemaking' practice of architects and masterplanners appointed - December 2016 - completed
  • Commission series of technical studies on key issues: November 2016 – Autumn 2017 - completed
  • Public engagement: February- March 2017 - completed
  • Community Planning Weekend - 24/25 March 2017 - completed
  • Engagement with stakeholder groups - completed
  • Vision for SPD - presented to IPG 4 July 2017 - completed
  • Preparation of and consultation on draft SPD: April - November 2017 - completed
  • Report of progress to IPG - 25 September 2017 - completed
  • Presentation of draft SPD to IPG - 30 October 2017 - completed
  • Approval to consult on draft SPD sought from cabinet - 6 December 2017 - approved
  • Formal consultation 11 December 2017 - noon 5 February 2018 - now closed
  • IPG held in public to share archaeology recommendations and consultation response themes - 19 March 2018 - completed
  • IPG held in public to share the consultation themes and actions - 14 May 2018 - completed
  • Overview & Scrutiny meeting to review the final draft of the SPD - 4 June 2018 - completed
  • Final SPD approved by Cabinet 20 June 2018 - completed
  • Coitbury House architect appointed for RIBA stages 0-4 - November 2018 - completed

Latest Status

The revised SPD; highlighting all the changes that were proposed to be made to it, was presented to the Cabinet (CWR) Committee on 20 June 2018, where it was adopted. The SPD has successfully completed its statutory three month challenge period (August 2018) and is accessible here.



At its meeting on the 27 November the Cabinet (CWR) Committee approved the next steps for the CWR project.



Henley Halebrown architects were appointed to complete RIBA stages 0-4 for the Coitbury House refurbishment. Cabinet CWR) Committee approved the recommendation for officers to commence a feasibility study for meanwhile uses on the bus station site.



Approval to produce a design brief for improvement works to the Lower High Street and Broadway was also granted. Officers are awaiting approval on the brief to procure a strategic development advisor, this decision will be made at the 12 December 2018 Cabinet.



Last Committee Report

Cabinet (Central Winchester Regeneration) Committee 27 November 2018



For details on the Central Winchester Regeneration Cabinet Committee, it’s members and it’s meetings please see this link.

Next Steps

  • Cabinet (CWR) Committee to pick up the next stage of the project - Autumn - Winter 2018 - in progress
  • Coitbury House Architect appointed for RIBA stages 0-4 - November 2018 - completed
  • Procure for the meanwhile uses bus station feasibility study - Winter 2018 - in progress
